Project Detail
Idlewood Road Roundabouts
- Planning
APPROVAL
- Environmental
DEMOLITION
- Design
CONSTRUCTION
- Construction
PHASE
- Completion
PHASE
Project Overview
The City of Tucker requested guidance on transportation safety by commissioning the North-South Connectivity Study and identified several projects of interest. Idlewood Road is a major connector between Tucker and the surrounding area. Idlewood Road has two schools, Tucker Middle School and Idlewood Elementary School. With the growing traffic and safety concerns the North-South Connectivity Study recommended the addition of two roundabouts to keep the flow of traffic running smoothly and safely.
Construction is scheduled to begin August 10, 2026 and last 18 to 24 months for both roundabouts.
Description:

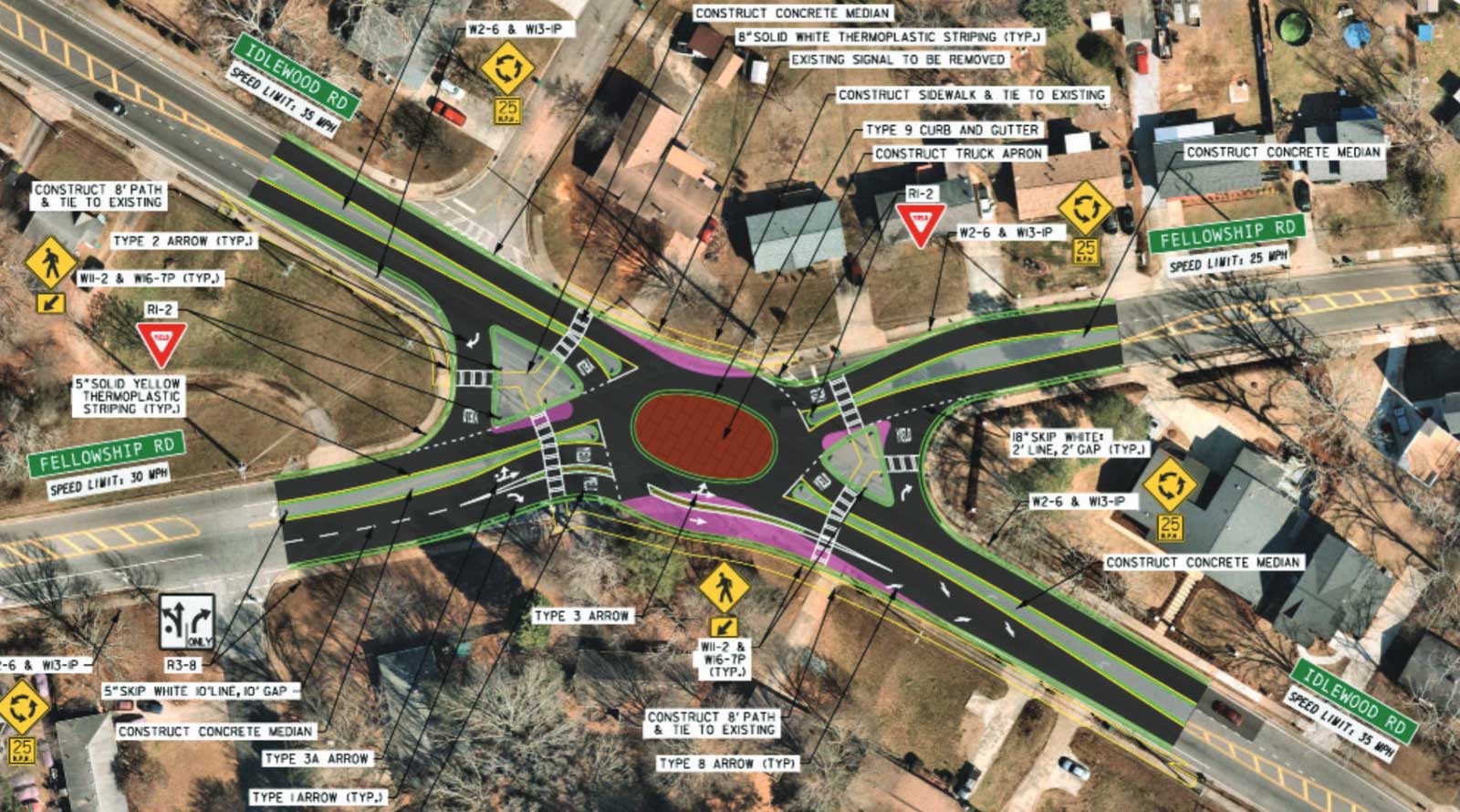

Fellowship Road and Sarr Parkway intersections on Idlewood Road are being upgraded from signals to modern urban roundabouts.
Objective:
To create smart and safer travel on one of Tucker’s busiest corridors.
Community Engagement:
- Public Information Open House – March 19, 2024
- Public Information Meeting – July 30, 2026
Project Documents
ROUNDABOUT FINAL PLANS
Community Presentation – July 30, 2026
Download the July 30, 2026 community presentation file
Construction is scheduled to start August 10, 2026 and last 18 to 24 months for both roundabouts.

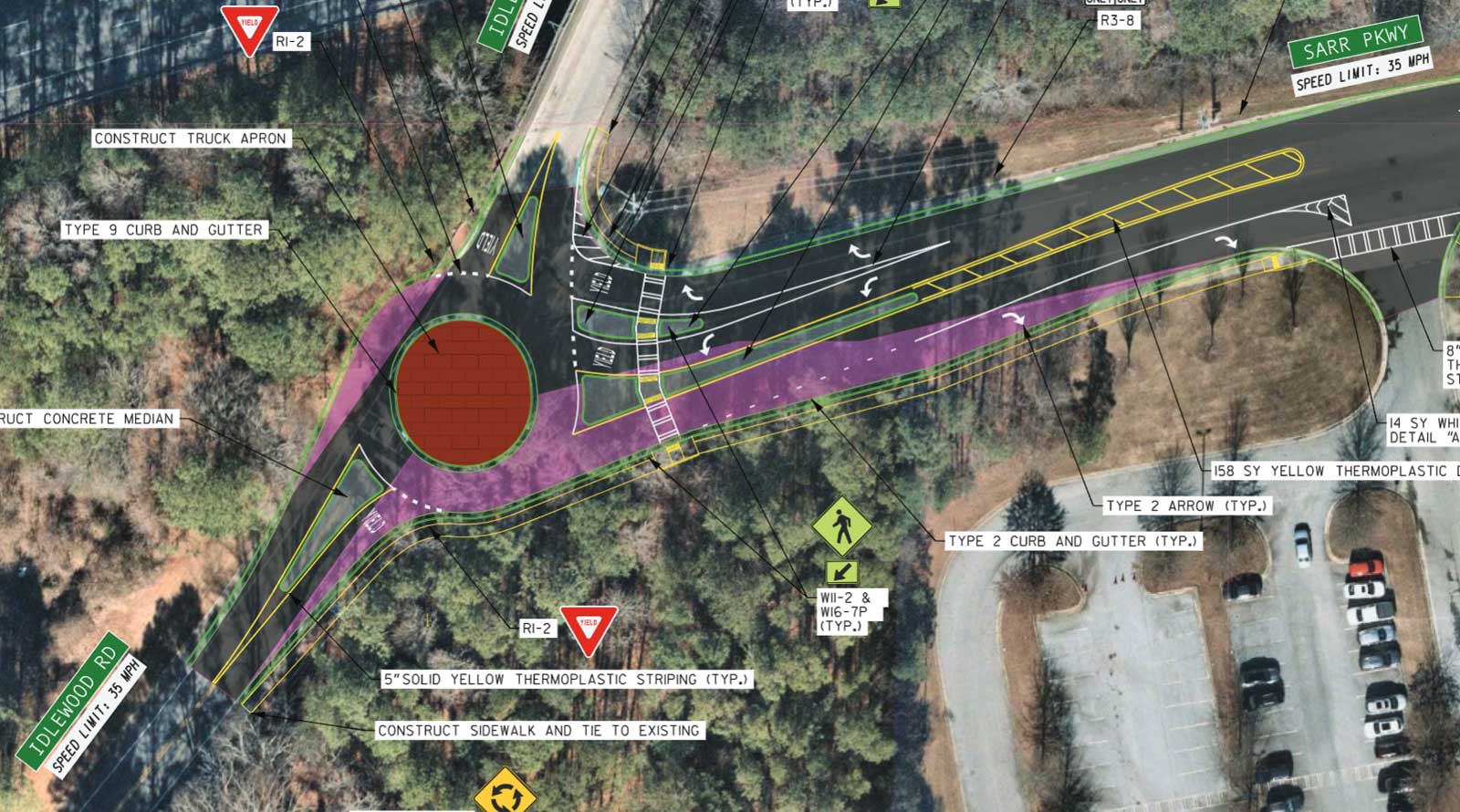

- 365 Calendar Days for Sarr Parkway
- 540 Concurrent Calendar Days of Fellowship Road
Work Hours 8 a.m. to 7 p.m.
Extended Hours may be considered
Lane Closures 9 a.m. to 4 p.m.
Notice to Proceed – August 10, 2026
